Integration ownership and the implementation responsibility matrix
Integrations are the single biggest source of post-contract disputes. The vendor assumed the buyer would deliver the payment switch API spec. The buyer assumed the vendor would handle it. Neither did. Six weeks before go-live, the project manager discovers the gap, and the change request lands.
This is what an implementation responsibility matrix prevents. It's a structured table based on the RACI framework that lists every task in the project and assigns one of four roles to each party: Responsible, Accountable, Consulted, Informed. Jamilyn Trainor, senior project manager at Müller Expo Services International, told Project-Management.com that RACI matrices "force owners of the project to clear timelines for approvals, provide clarity, push decisions faster, and call out gaps before they become failures."
For a core banking project, the implementation responsibility matrix should cover every integration point, every test cycle, every regulatory submission, and every handover from build to operations. And it must include third parties. If your national payment switch operator needs to certify the connection, put their name on the matrix. If the credit bureau requires a 90-day testing window, that goes on the matrix too.
A few rules for using the implementation responsibility matrix well:
-
One Accountable role per task, never two. Shared accountability is no accountability.
-
Update the matrix whenever scope changes.
-
Get the third parties to sign their rows along with the vendor and the buyer.
Vendors who push back on signing an implementation responsibility matrix are telling you something. Listen.
Data migration requirements
Data migration sounds like a technical chore. It's actually the work that decides whether the project succeeds. Realistic migration covers extraction from legacy systems, cleansing, mapping, transformation, reconciliation, and parallel runs before cutover. A Tata Consultancy Services white paper on core banking migration describes rollout strategies such as big bang and phased delivery, with parallel run posting transactions to both source and target until reconciliation passes.
Vendors almost always expect the buyer to deliver clean source data. That expectation is rarely realistic. If your legacy core has been running since 1998, you have duplicate customer records and addresses in three formats, and at least one collateral field has been used to store SMS reminders. Cleansing that takes months and dedicated people, and "the bank will provide clean data" in a contract is a clause that quietly transfers tens of thousands of hours of work to your operations team.
Confirm the following in writing before signing:
-
Who owns cleansing of source data, with named teams on both sides
-
How many migration rehearsals are included in the price (three in staging is a sensible minimum, as recommended by vLink Info's migration guide)
-
The reconciliation threshold that triggers a halt, and who has authority to call it
-
Who signs off on cutover, and what the rollback plan looks like if cutover fails
If the vendor's response to any of those is "we'll figure it out during the project," you have a software license with a hopeful project plan attached.
Support model and operating responsibilities
Support models look similar on the cover page and differ enormously in practice. Break-fix support means the vendor responds when something breaks, full stop. Managed services means the vendor runs day-two operations, with patching and monitoring included. Shared operating models split the work, which is where most disputes start.
Read the Service Level Agreement (SLA) line by line. What's the response time for a Priority 1 incident? What's the resolution time? Does the SLA pause during business hours or run 24/7? What's the escalation path when the first-line team can't fix it? And critically, what happens to the customizations your project team built during implementation? Many vendor SLAs exclude custom code from support, which means your most important workflows are the ones the vendor won't touch when they break.
Day-two operations are the quiet cost center. Patching, vulnerability management, monitoring, capacity planning, and disaster recovery testing all need owners. The core banking architecture you signed off on assumes someone is running it. If your contract is silent, that someone is you. The implementation responsibility matrix should extend past go-live into the operating phase, so the handover from project team to run team has clear lines.
Vendor validation checklist
This is your minimum due diligence for the early stage of evaluation. Get written commitments on each item before signing. Vendors who hesitate on any of these are flagging future risk, and you should price that risk into the negotiation or walk away.
Organizations should verify several critical areas before moving from evaluation to implementation:
-
Scope document listing every module and product variant, with included reports named
-

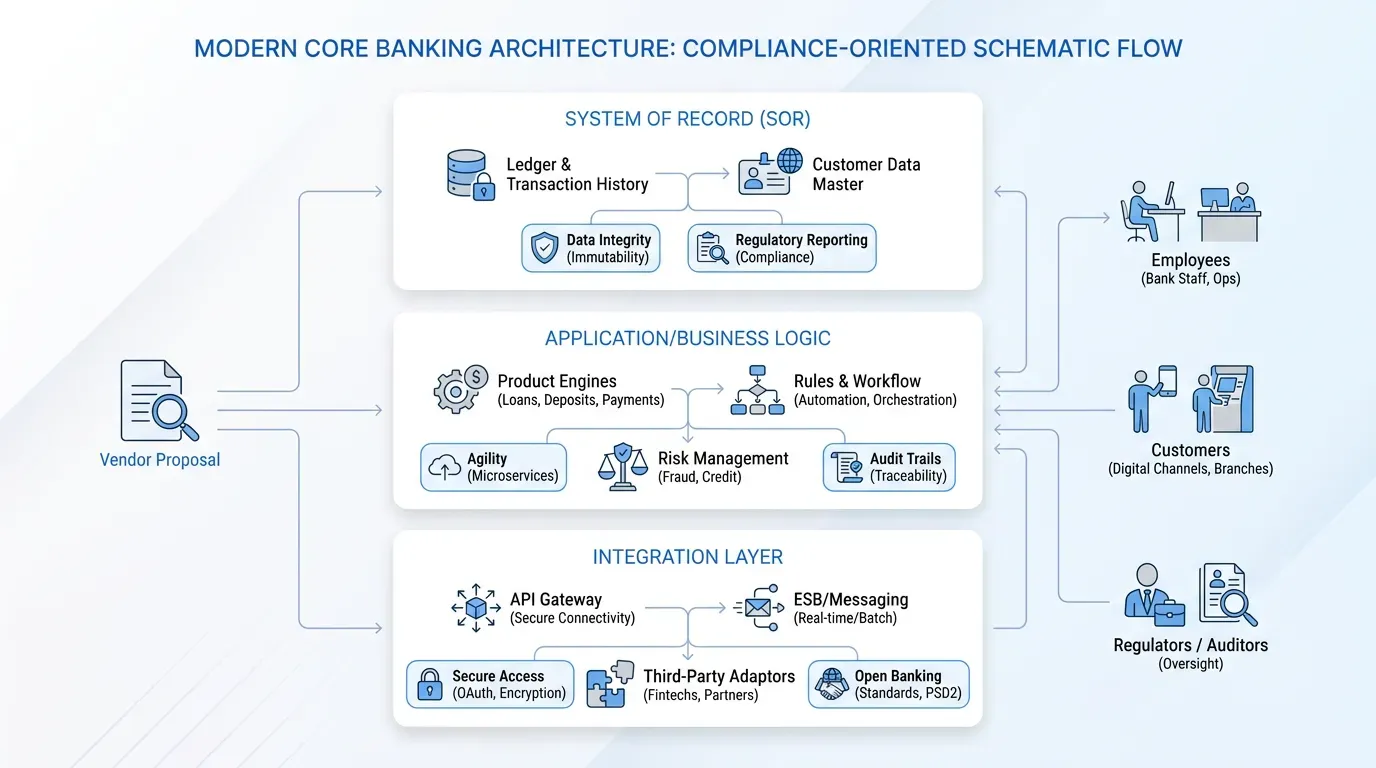

Layer-by-layer breakdown of the core banking architecture with license and hosting responsibility named, and backup responsibility stated separately
-
Full list of integrations with third parties identified by name
-
Implementation responsibility matrix covering build, test, migration, cutover, and operations
-
Data migration plan with cleansing ownership and rehearsal count, plus reconciliation thresholds
-
SLA with response times and escalation path, plus explicit treatment of customizations
-
Governance model with steering committee composition and decision rights
-
Exit terms covering data export format and transition assistance, with intellectual property addressed
The checklist looks long because the meaning of core banking solution is long. That's the point. Short checklists hide expensive surprises.
Request a written scope and responsibility matrix
The meaning of core banking solution only becomes real when every line item has a named owner. A polished sales deck is not a scope document. A handshake on integrations is not an implementation responsibility matrix. If a shortlisted vendor cannot or will not produce both before contract signature, that's your answer about how the project will be managed once your signature is on the page.
Make the written scope and responsibility matrix a non-negotiable part of procurement when you define the meaning of core banking solution. Not nice-to-have, not later, not after the kickoff workshop. Before signing. Walk through every layer of the core banking architecture with the vendor, line by line, and watch where they hesitate. That's where the scope gap is.
